Project Four

For which project? That link just directs us to the general project page :slight_smile:

2 toughswithces for thepark one for toughswitch and gsm for mimas.

Project 4 - Plan of Action

Preparation

9-13 March
Ordering and collection of equipment.
14 March
Brackets to be made and sent for galvanizing the following week.

The installation of links on highsites will happen in 3 stages.

Stage 1 - Subsidiary Links
21 March

Install Ariel equipment to ThePark
Install KM-Airwolf equipment to ThePark
Align Hyperlink (Tafseer) - ssid will be supplied for scanning purposes
Align Ironman (Ironman) - ssid will be supplied for scanning purposes

Stage 2 - ThePark
28 March

Install the 3 links on ThePark; Mimas, Km-Airwolf and Ariel

Stage 3 - Mimas
4 April
Install 3 links on Mimas; Ironman, Hyperlink and ThePark
Closed non-slip shoes and long trousers to be worn at all times on site.
Red zones are out of bounds due to excessive RF radiation.
No CTWUG branded apparel to be worn on site.
Maximum 5 people allowed on site.

We are still waiting for the correct ssid for ironman and hyperlink to scan for

Ironman->Mimas
http://ctwug.za.net/ironman2

Hi ironman

I actually mean we are waiting for the ssid’s that you and hyperlink can scan for. The security company thay has 5.8ghz equipment up there will give the ssid’s that they are using giving you and hyperlink something to point at.

When we go to mimas it will be a 5 man mission and all 5 men will now exactly what to do, at this point you would have aligned already and your kit will be in bridge mode so we can scan for you.

If all goes well then we’ll hopefully only visit mimas once.

OK…No props

Morning all

The galvanizing of the brackets is taking longer than was expected, I will only be able to collect it next week. This means we will have to reschedule, this affects Airwolf and Ariel installations. I’m not sure when but will update as soon as we have decided. Then the mimas link we cant get an appointment for the 4th sparky is trying book the 11th April for us.

Just a few updates on this project.

Thepark update

Installation happened on Saturday, this site is now up and running and we have made a plan to temporarily connect it to airwolf. Thepark has its first client Bushwood who was moved from Airwolf to thepark. We have aligned the three links to ariel Airwolf and mimas.

Mimas update

We are struggling to find a date to do the install, will keep you guys informed.

Ariel update

If all goes well it will happen this Sunday.

Airwolf update

Finding a date to get the all the installers there at same time seems more difficult than we thought. Hopefully we can do it the 11th April. This site is not only the install for thepark we need to do some other stuff to, which could make it a half day job.

At least we making some progress and in time well have a “super-junction” build for transit traffic.

Ariel update

If all goes well it will happen this Sunday.

The installation happen as planned, the link is up and running and is really performing well.

Installation happened on Saturday, this site is now up and running and we have made a plan to temporarily connect it to airwolf.

This link has been disabled until we can install the new AC equipment

Hi guys

To keep inline with way the wug has been doing things over the years now I ask Bushwood the founder of the site to please rename ThePark after any moon in our solar system as it is a CTwug highsite. The name that he came up with was [SIZE=3]Lapetus, Lapetus and Mimas are both moons of Saturn.

For new clients of Lapetus please scan for ssid: [/SIZE]http://ctwug.za.net/Lapetus-sec1.

Hi all

Just an update

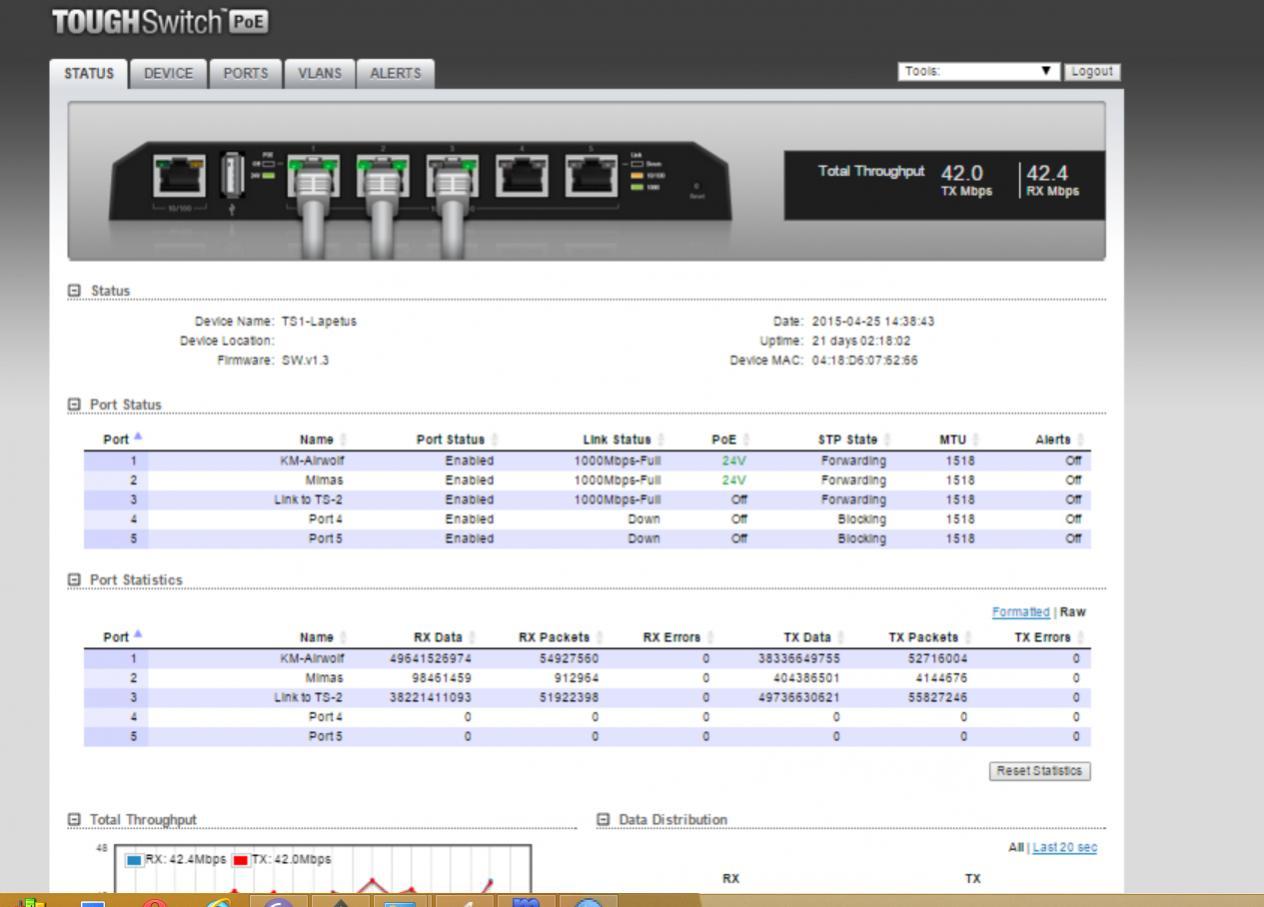

Airwolf we have an install date for 25th April, Mimas we not to sure when this will happen porky/sparky is struggling to find an install date for us. Will keep you guys up to date as soon as we know more.

Hey everyone

Airwolf install for the Lapetus link did happen today with no downtime, good news is the link is performing very well, big thanks to the guys that came out to help, I know it wasn’t the best conditions(very cold and misty) 7am but you guys did an awesome job.

Wolf
Mighty_mike
Dan
Landrover
Weasel

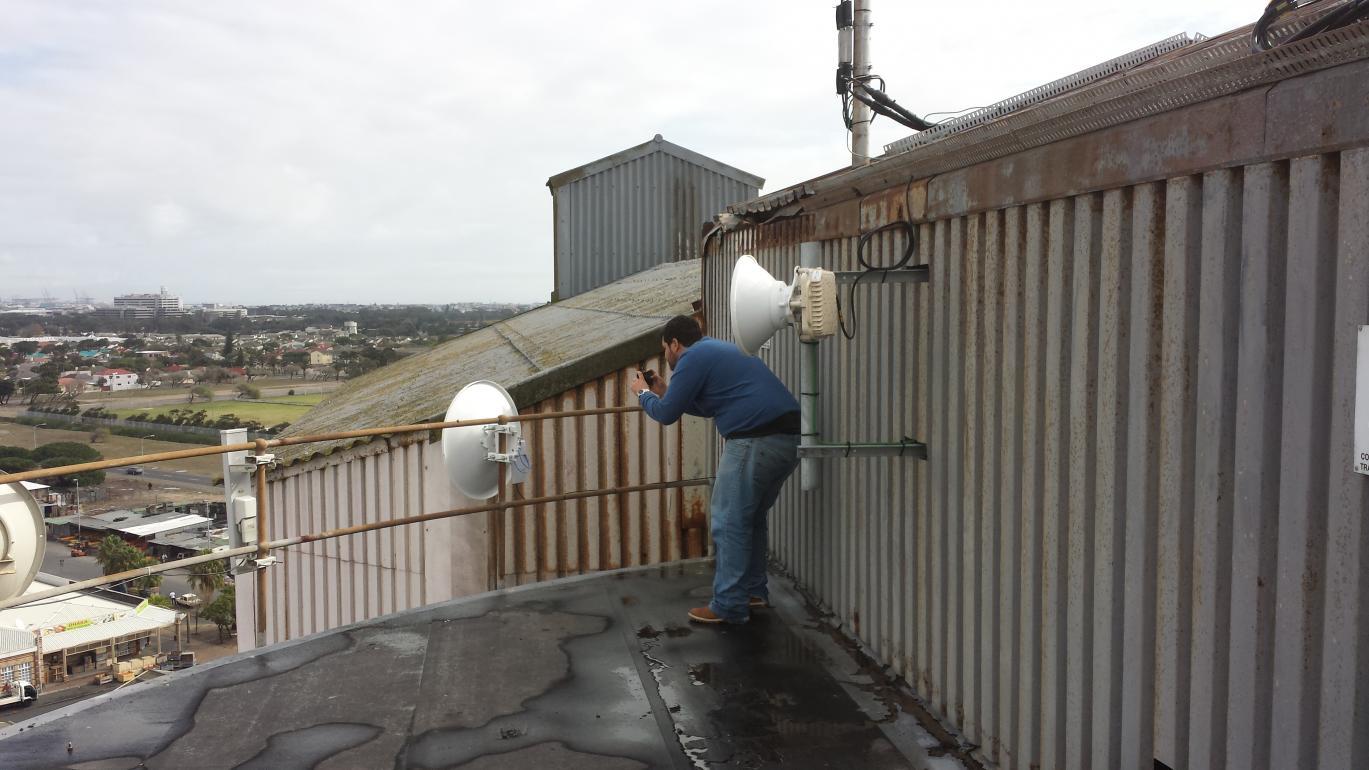

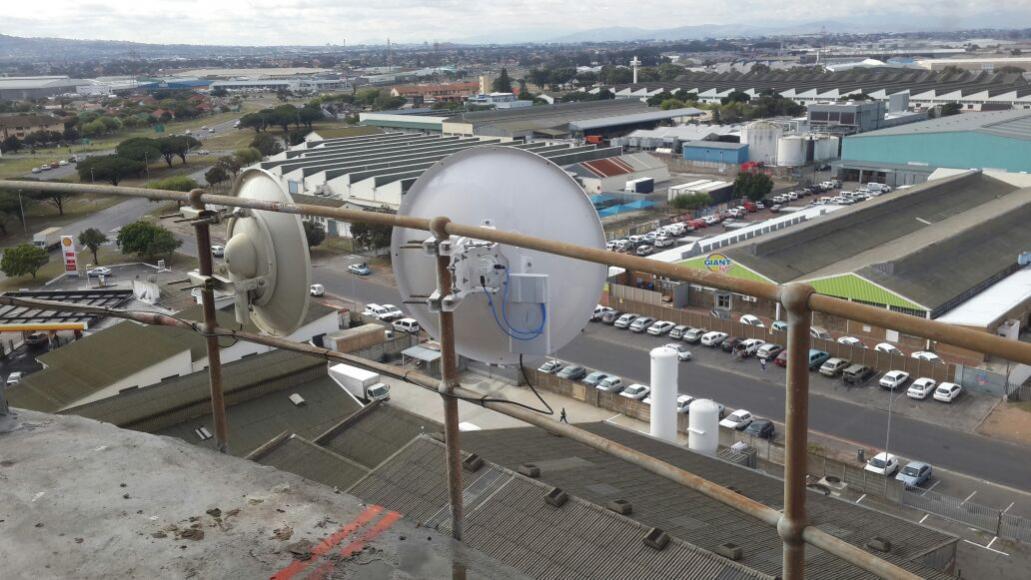

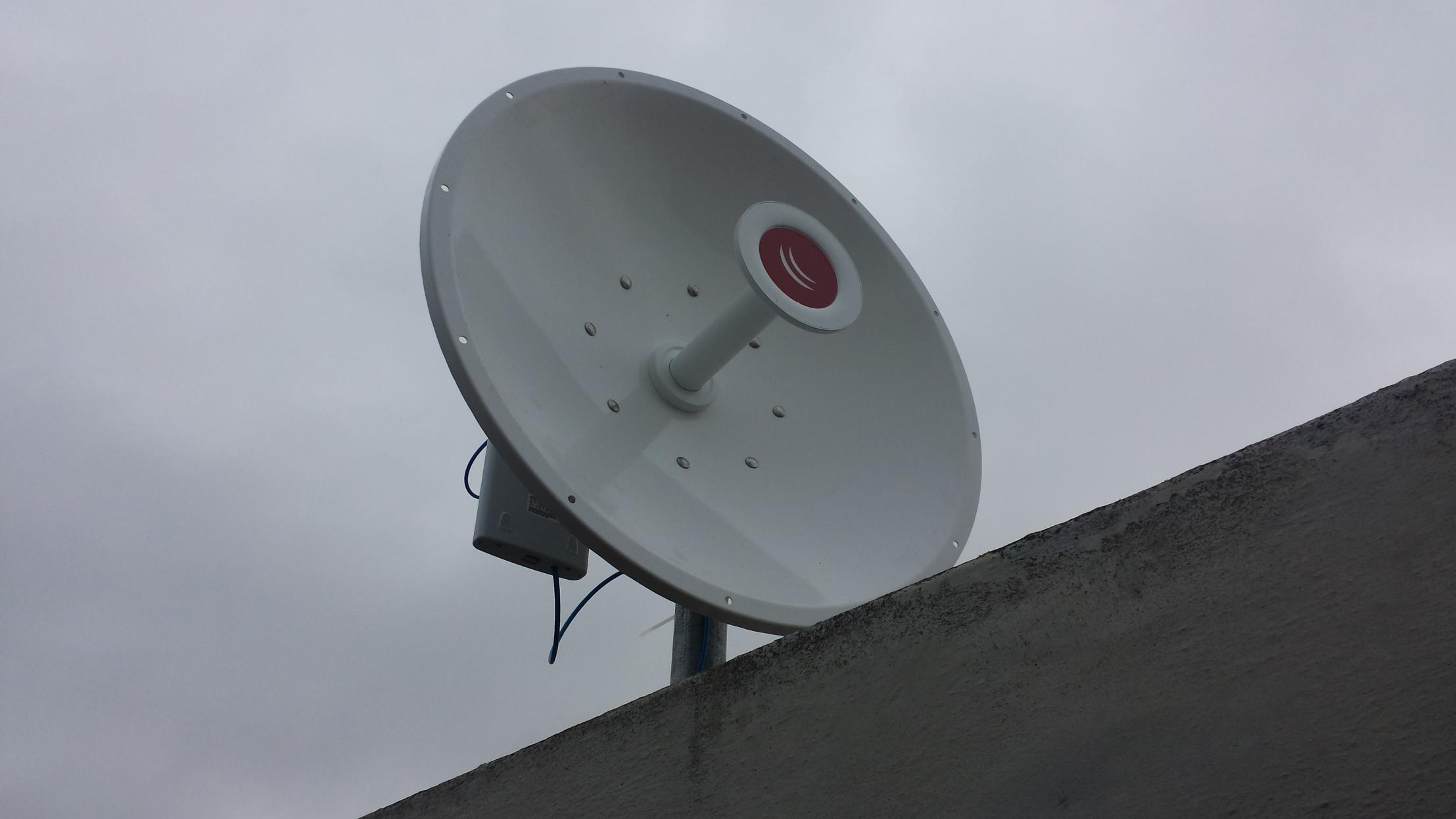

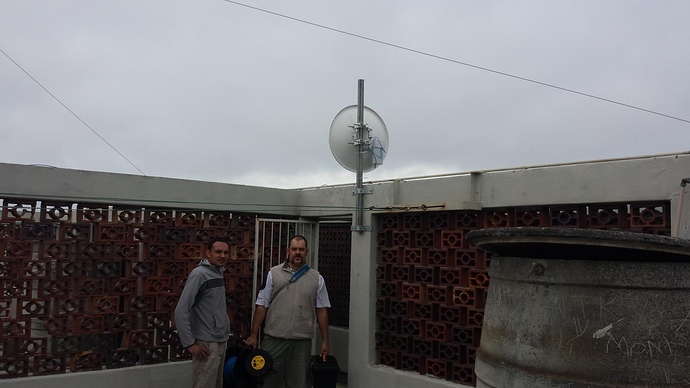

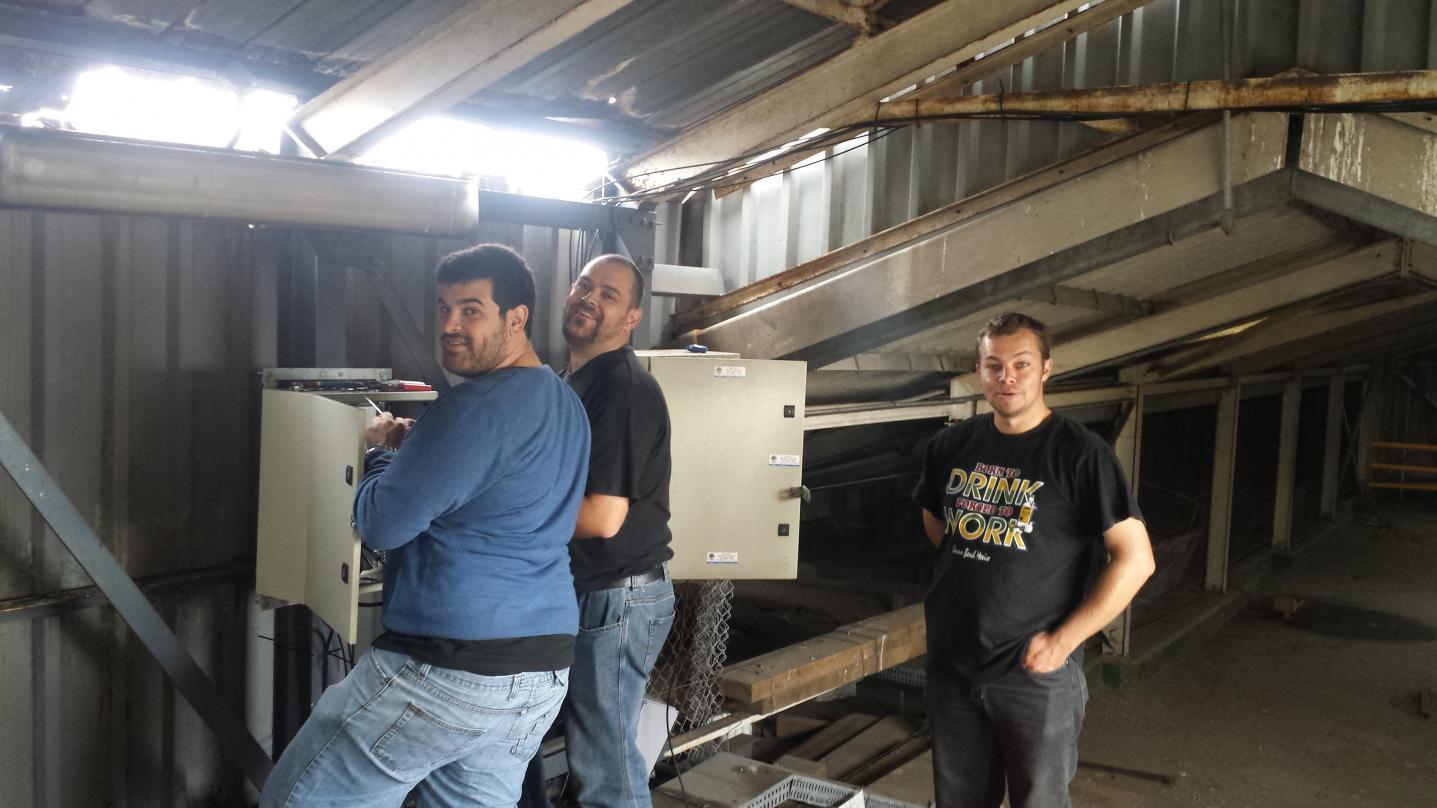

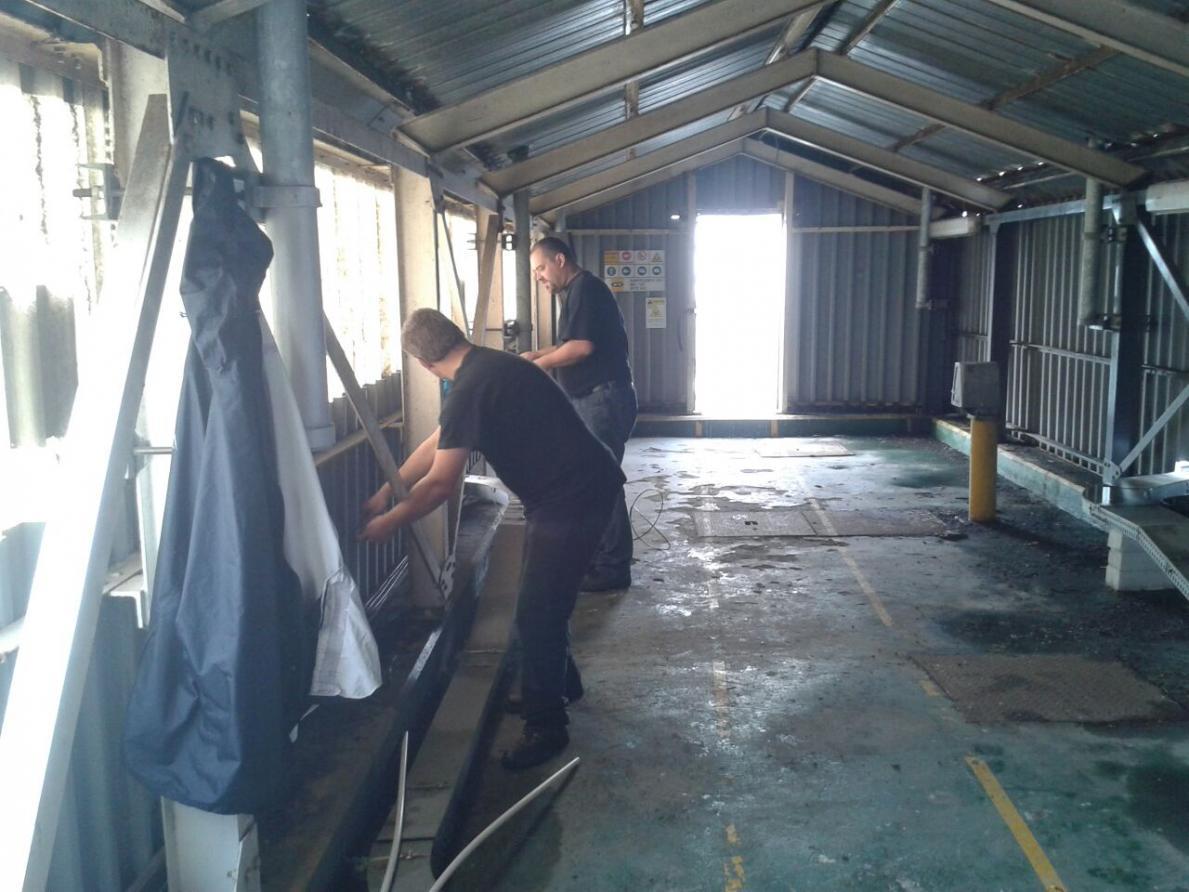

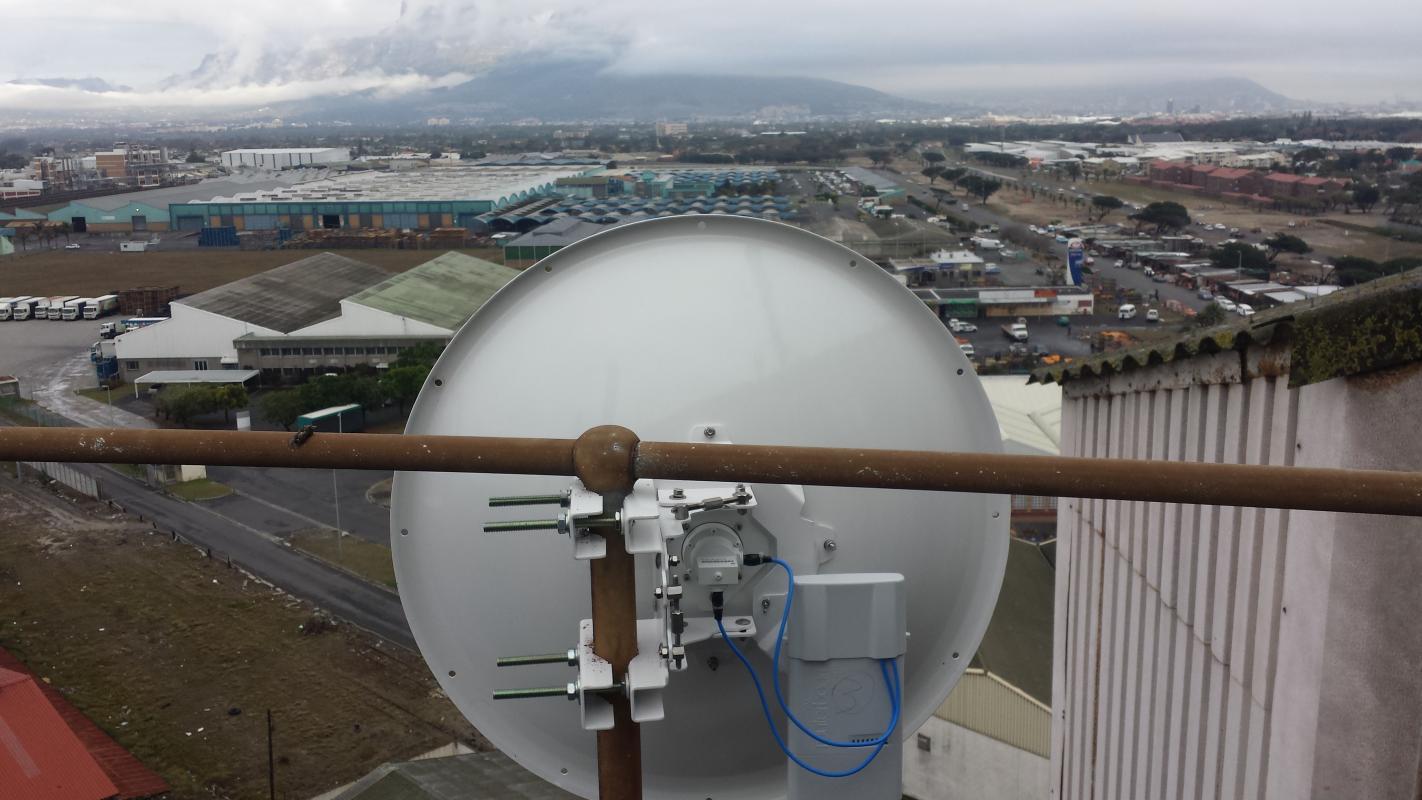

I will upload some photos at a later stage

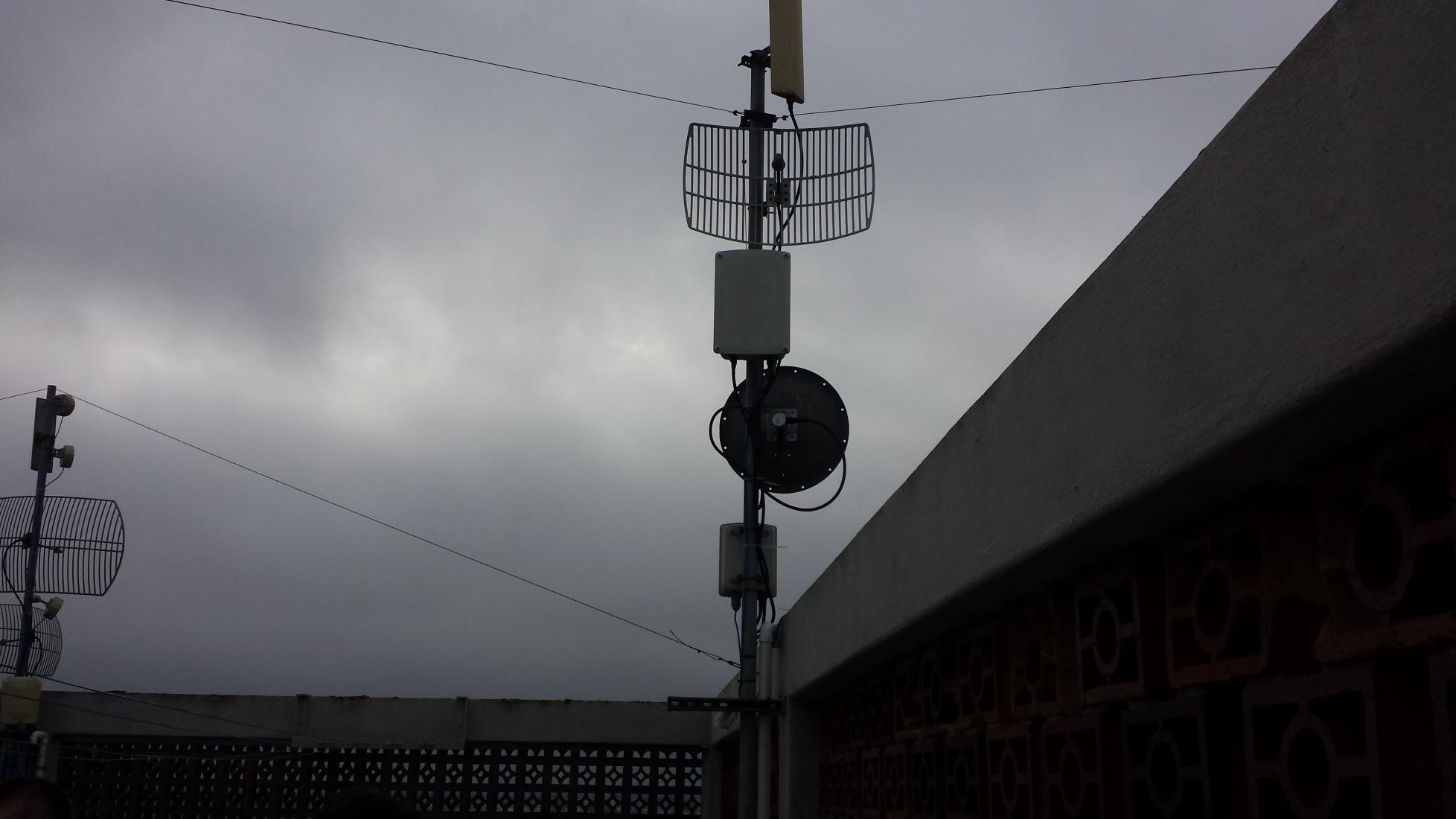

Some pics





Mimas 5-4-3 is alive!!!
5 men 4 hours 3 links is what happened today. Myself, Dan Hyperlink, Wolf and porky went up the silo this morning to get the links up in only 4 hours.

The hyperlink and lapetus links are up and running, still need some fine tuning. Ironman links needs a bit more tuning from ironman side and alignment and should be running tomorow some time.

I would like to take the time to say thank you to everyone involved that help make this happen.

Ariel install
Dan and mde

Airwolf install
Weasel, wolf, Dan, spotpro Mighty_mike and landrover

Lapetus install
Bushwood, Dan and Wolf

Mimas install
Porky, Dan, Hyperlink and Wolf

Thankyou nextlevel for assembling the the enclosure for us, a job well done

Also thanks to the committee for supporting the project all the way and lastly thanks to Ironman for all your patience let hope it pays off with the alignment.

Pics will follow

Hi Five guys! Well done.






to see more pics please go checkout our facebook page

Thanks for all your hard work guys!!! I think there should be a Ctwug award for team of the year lol

/me hands it to #ctwug-bellville
